Google Phase II – Moving Right Along
Through the month of April, crews poured 96 columns and column footings. There are 22 footings and columns left to go before we start forming the north wall. Five out …
Through the month of April, crews poured 96 columns and column footings. There are 22 footings and columns left to go before we start forming the north wall. Five out …
Workers are wrapping up the exterior cladding and site work is scheduled to be complete at the end of May. Mechanical, electrical, and plumbing rough in is wrapping up and …

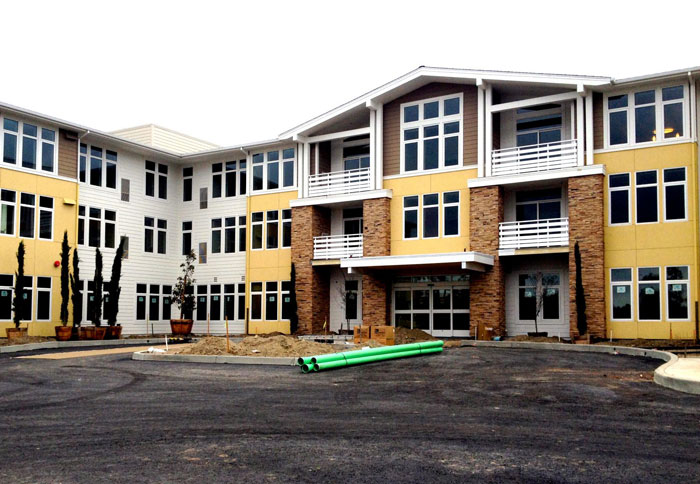

Huntington Beach is nearing occupancy. Workers are diligently putting final touches on the building and site work. Final inspections are in progress and residents are scheduled to move in by …
Crews are now complete with all residential drywall work. Common area drywall will continue through May. Exterior cladding at the roof level is wrapping up and we are working on …
The Astro continues to move along at a good pace and the team is working hard to keep the momentum going. On the ground level there are a few ‘feature’ …
Workers are currently forming and pouring structural footings, walls, and columns at the SW and SE quadrants in advance of our first SOG pour on 4/16. The first shortcrete perimeter …
This month we will be installing gypsum wall board in the last of the L9 and ground floor Townhouse units. Finish paint is complete on levels three and four, and …

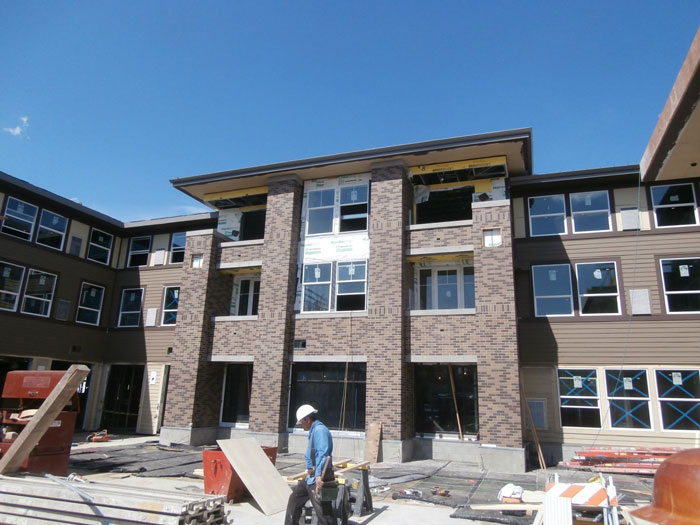

The exterior envelope work is wrapping up and site work is in progress. Storefront glazing systems will be complete by the end of April. The interior mechanical, electrical, and plumbing …
